New Condo Key Collection in Singapore: What to Do in the First 30 Days

You've waited years for this moment. Your new condo keys are finally here. What you do in the next 30 days determines whether you get your defects fixed for free — or pay out of pocket. Here's the complete step-by-step guide for Singapore new homeowners.

New Condo Key Collection in Singapore: What to Do in the First 30 Days
Photo by Tierra Mallorca / Unsplash

Property Management | Singapore New Homeowners | March 2026 CEA Licensed · mychoicehomez.com | 7 min rea

The keys are finally in your hand.

You have waited — two years, three years, sometimes longer. You have made the progressive payments. Survived the construction delay anxiety. Watched the building rise floor by floor. And now you are standing at the door of your new home, holding the most expensive set of keys you have ever owned.

This is one of the best days of your life. It is also one of the most important 30-day windows you will ever have as a property owner.

What you do — and what you do not do — in the month after key collection determines whether your developer fixes your defects for free, or whether those costs fall entirely on you. Most homeowners do not know the rules. Here is the complete guide.


Step 1: Understand What TOP and NOVP Mean

Before key collection happens, two things must occur.

TOP (Temporary Occupation Permit) is issued by the Building and Construction Authority (BCA) when the development is certified fit for occupation. When you see TOP announced, it means the building has passed structural and safety checks. It does not mean your individual unit is defect-free — that is your job to verify.

NOVP (Notice of Vacant Possession) is the letter your developer sends after TOP is granted. It officially notifies you that you may collect your keys and take possession of your unit. Your NOVP letter will specify the date, time slot, and location for key collection — typically the developer's office or a designated collection centre.

Important: Your Defects Liability Period (DLP) clock starts on the date you collect your keys — not the TOP date, not the NOVP date. The moment you physically receive those keys, the 12-month window begins.


Step 2: What to Bring on Key Collection Day

Key collection is not just a handover. It is also the beginning of your documentation trail. Bring:

  • Your NRIC or passport (and co-owner's if applicable)
  • Your NOVP letter
  • A fully charged phone with a good camera
  • Masking tape and a marker (for flagging defects)
  • A notepad or use a defects app (Report and Run is commonly used)
  • Any forms the developer has sent in advance — some require pre-registration or digital sign-offs

Do not rush. Block out a minimum of two to three hours. A thorough walkthrough of a standard two- or three-bedroom unit takes longer than most homeowners expect.


Step 3: The First Walkthrough — What You Are Looking For

This is the most important 90 minutes of your key collection day. Before you think about renovation, before you call your interior designer, before you order that first cup of coffee in your new kitchen — you need to walk every inch of this unit with fresh eyes and document what you find.

What to check:

  • Walls and ceilings: Cracks, uneven surfaces, paint bubbles, staining, or water marks
  • Floors and tiles: Hollow tiles (tap gently — a hollow sound indicates poor adhesion), cracks, chips, or lippage between tiles
  • Windows and doors: Misalignment, gaps in seals, smooth operation of all mechanisms, no scratches on glass
  • Electrical fittings: Test every power point, light switch, and appliance. Bring a phone charger and a small lamp to check all sockets
  • Plumbing: Run every tap, flush every toilet, check under every sink for signs of leakage or poor sealing
  • Waterproofing: Check the bathroom floors and walls carefully — water staining or damp patches near the base of walls are early warning signs
  • Carpentry and fittings: Open and close every cabinet door and drawer. Check alignment, gaps, and the quality of hinges and handles
  • Air conditioning: Turn on every unit if possible — check cooling efficiency and listen for unusual sounds

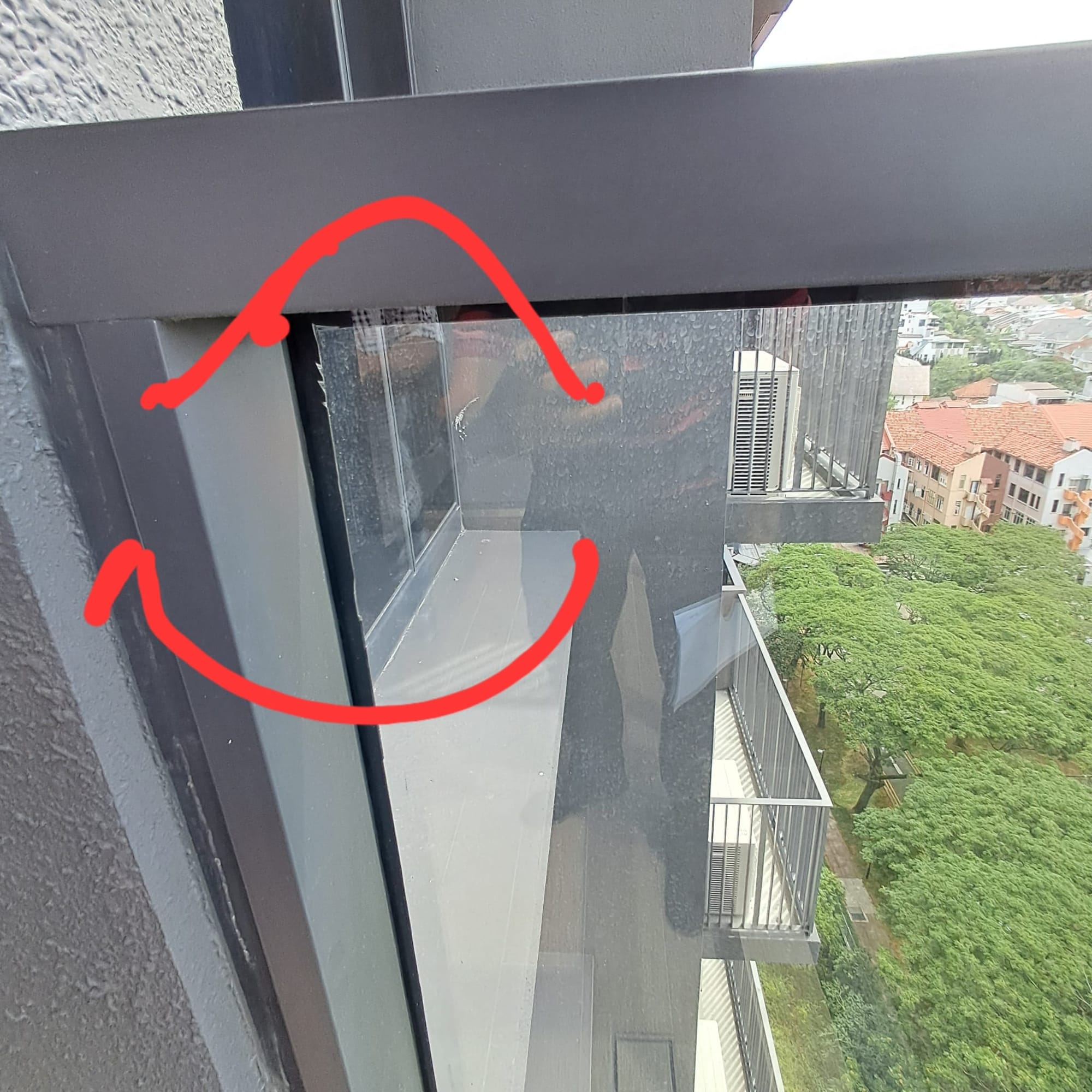

Mark every defect with masking tape. Photograph everything. Date-stamp your photos. This documentation is your legal record.


Step 4: Submit Your Defects List — Before Renovation Starts

Once you have completed your walkthrough, compile your findings into a defects list and submit it to the developer via the Managing Agent (MA).

The MA is the management company appointed to oversee the development on behalf of the MCST. They are your official channel for all defect submissions during the DLP. Do not submit directly to the developer or main contractor — route everything through the MA in writing.

Most developers provide a standard defect report form. Use it. Include:

  • Unit number
  • Location of each defect within the unit
  • Description of the defect
  • Photographs (timestamped)
  • Date of submission

The MA will log your submission, coordinate with the developer or main contractor, and schedule an inspection appointment. Keep copies of everything you submit.

The critical rule: Submit your defects list before any renovation work begins. Once your contractor enters the unit and starts work, the developer can — and legally may — argue that any subsequently discovered defect was caused by your renovation rather than their workmanship. You lose the claim. You pay out of pocket.


Step 5: Know Your DLP Rights

Your Defects Liability Period (DLP) gives you 12 months from key collection to submit defects that the developer must rectify at no cost to you. This is a legal right under Singapore's Housing Developers (Control and Licensing) Act.

Beyond the 12-month DLP, there is an additional layer of protection:

Structural and waterproofing warranty — up to 10 years covering external wall seepage, roof or facade leaks, and structural integrity issues. These defects can be catastrophic in cost if left undetected — and they are not always visible in the first walkthrough.

For a full breakdown of what the DLP covers, what qualifies under the 10-year warranty, and how to protect your claims — read our complete guide here: Your New Condo Keys Are Coming. Don't Lose Thousands By Not Knowing This.


Step 6: Consider a Professional Defects Inspector

Most homeowners do their defects walkthrough themselves. Some hire a professional Building Surveyor instead. Here is the honest case for both.

DIY walkthrough: Free. Works if you are methodical, have time, and know what to look for. The limitation is that untrained eyes miss things — especially waterproofing issues, hollow tiles, and M&E defects that are not immediately visible.

Professional Building Surveyor: Typically S$500–S$3,000 depending on unit size. Their report carries professional accreditation that is significantly harder for a developer to dispute than a homeowner's own documentation. For a home worth S$1M or more, this is not where you save money.

For a detailed breakdown of the DIY vs professional inspection decision — including the cost-benefit analysis and what a professional inspection actually covers — read: Don't Touch That Paintbrush Yet: The Case for a Professional Defects Inspection in 2026


What Happens After You Submit

Once your defects list is submitted to the MA:

  1. The MA logs your submission and forwards it to the developer or main contractor
  2. An inspection appointment is scheduled — typically within 2–4 weeks
  3. The developer's representative inspects the flagged defects
  4. Accepted defects are scheduled for rectification
  5. You are notified when works are completed and asked to verify

Track every step. If the developer disputes a defect, your timestamped photos and professional report are your evidence. If rectification is delayed beyond the DLP window, document the delay in writing — you may still have grounds for a claim.


After the Defects Are Settled: The Next Decision

Once your defects are documented and submitted, you can proceed to renovation planning.

For many new homeowners, this moment also raises a larger question: what is the right next move for your property portfolio?

If you purchased your new home as an upgrade from an HDB — your HDB sale, CPF top-up, and renovation costs all feed into a picture that is worth reviewing with a property advisor before you make the next move. If you are planning to rent out the unit, the key collection period is the right time to understand tenancy structures, maintenance obligations, and how to protect your asset.

These are decisions that compound over time. Getting them right at key collection — not 12 months later — is the difference between a well-managed asset and one that costs you more than it should.
